SURFACE CUT & CAP PROPOSAL
HELI-PORTABLE SURFACE
CUT & CAP ATHABASCA OIL CORP. TWO-WELL PROGRAM
Prepared for Athabasca Oil Corporation. A field-ready plan for two surface cut and cap using Innovative Well Abandonment's heli-portable ultra-high-pressure cutting system.
0
Wellbores
Surface abandonment scope
0
Licences
Included in this program
0
Project Days
Including mob / demob
Compliant








01 — Project Area
Two-Area Footprint
Two Athabasca Oil Corporation well locations with distinct readiness requirements for surface abandonment.
Well 13-11
100/13-11-091-19W4 · Licence A000280161
Downhole abandonment must be confirmed before mobilization to site for the surface cut and cap.
Well 10-17
100/10-17-094-21W4 · Licence A000062618
Downhole abandonment must be confirmed before mobilization to site for the surface cut and cap.
02 — Access
Field Access Scenarios
A heli-portable approach minimizes access requirements while keeping staging and mobilization suited to each site.
Heli-Portable Access
The portable cut-and-cap equipment can be transported directly to each well location.
No Road Required
The portable spread avoids the need to construct an access road to complete the work.
Small Staging Area
Staging is selected to suit confirmed site conditions and support efficient mobilization.
Field conditions require confirmation
Access method, staging requirements and schedule will be confirmed from the current conditions at each well location before mobilization.
Field Access Assessment
Athabasca Oil Corporation will confirm access conditions for both locations.
Equipment Selection
The portable equipment spread is confirmed from that assessment.
Mobilization Planning
Confirmed access conditions determine the final mobilization plan.
03 — Approach
Our Method
How a heli-portable package compares with a conventional access-first surface cut & cap on a remote site.
Cutting method
Standard
Conventional cut-backhoe & welder requiring full lease access
Our approach
Remote portable ultra-high-pressure cutting unit, packable to the wellbore
Site disturbance
Standard
Access road and large worksite footprint
Our approach
Small well-centre work area where conditions allow
Remote contingency
Standard
Project deferred until a road can be built
Our approach
No road required
Staging
Standard
New staging pad constructed near the wellbore
Our approach
Small staging selected to suit confirmed access at each Athabasca location
04 — Rates
Equipment & Rate Schedule
Itemized project estimate showing the supplied units, quantities, rates and extended totals.
Primary Equipment
UHP PUMPING SYSTEM
$13,000.00
Well/Day × 2 at $6,500.00
$2,500.00
Tracked Skid Steer
Weekly × 1 at $2,500.00
$2,000.00
16' Dump Trailer
Daily × 4 at $500.00
$1,500.00
Tooling
One time × 1 at $1,500.00
Logistics & Mobilization
Support Truck #1
Hourly × 44 at $25.00
$1,100.00
Support Truck #2
Hourly × 28 at $25.00
$700.00
Support Truck Mobilization
KM × 1300 at $1.75
$2,275.00
Support Truck Demobilization
KM × 1300 at $1.75
$2,275.00
Subsistence
Day × 6 at $275.00
$1,650.00
Crew Labour
Project Manager
Hourly × 44 at $140.00
$6,160.00
Supervisor 1
Hourly × 44 at $120.00
$5,280.00
Operator 1
Hourly × 44 at $100.00
$4,400.00
Prep
Hourly × 10 at $140.00
$1,400.00
Standby
Day × 1 at $4,500.00
$4,500.00
Estimated Project Total
Based on the units and quantities listed above.
$48,740.00
05 — Assumptions
Assumptions & Conditions
The basis of estimate for this proposal, including access, schedule and operating conditions.
Access Method
Final access and staging requirements follow Athabasca Oil Corporation's field assessment. Pricing is adjusted once the access method is confirmed.
Well Locations
The program covers 100/13-11-091-19W4 and 100/10-17-094-21W4.
Rates & Surcharges
Rates are quoted without fuel surcharge unless otherwise directed. Standard daylight operating hours apply. There will be no overtime.
Estimate Basis
The project estimate is based on the units, quantities and rates listed in the supplied schedule, including mobilization and demobilization.
STAGING
Staging site has been selected as Paramount Legend plant site - 12-31-094-18W4
REGULATORY
D20-compliant digital records with attached visual evidence for bulletproof OWA auditing.
06 — Contacts
Contacts & Next Steps
Leads on both sides of the project, and what has to close before the crew mobilizes.

Innovative Well Abandonment
Contractor



Athabasca Oil Corporation
Client
Kyle Westgate, P.Eng.
Completions Superintendent | Athabasca Oil Corporation

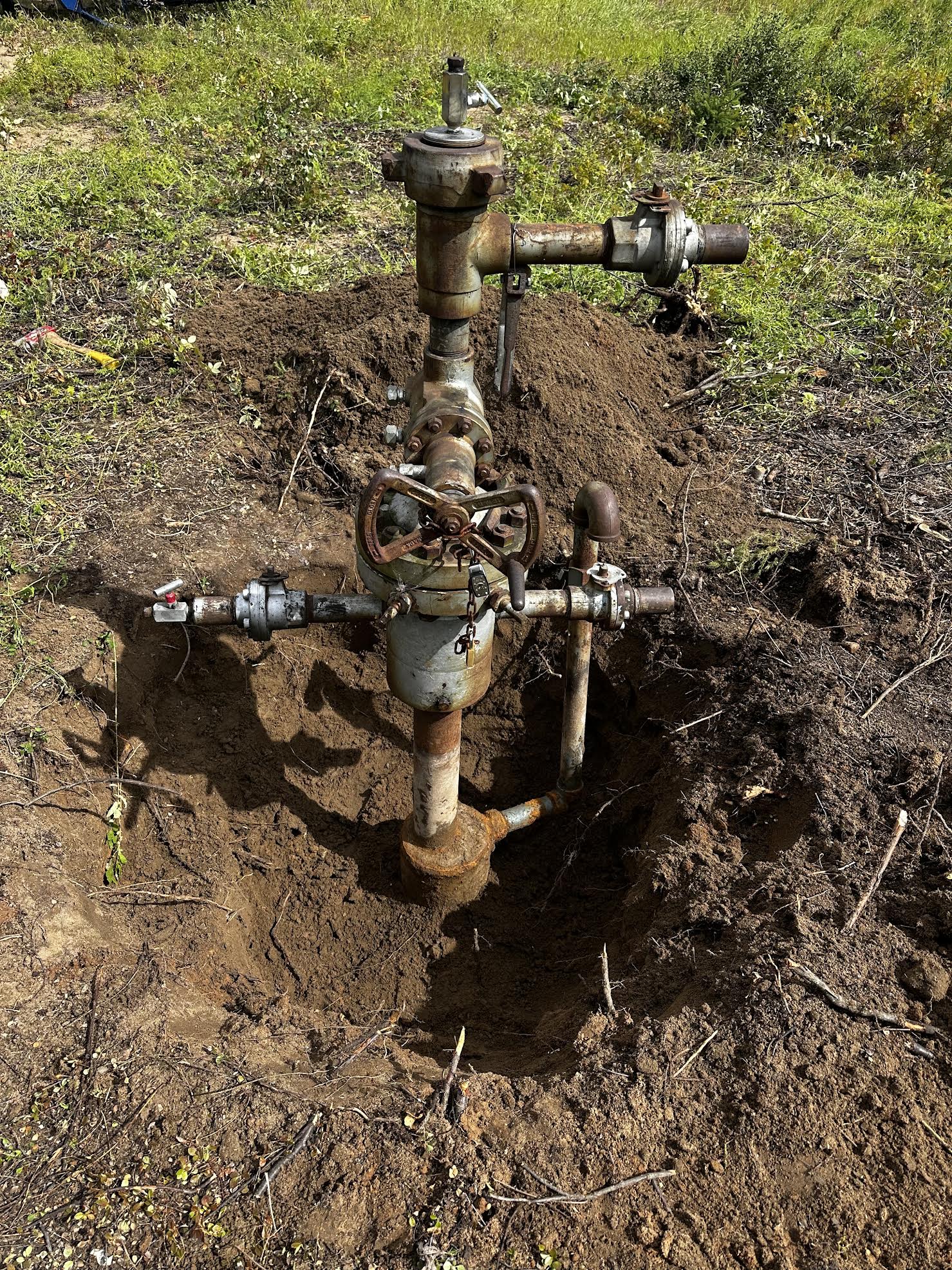

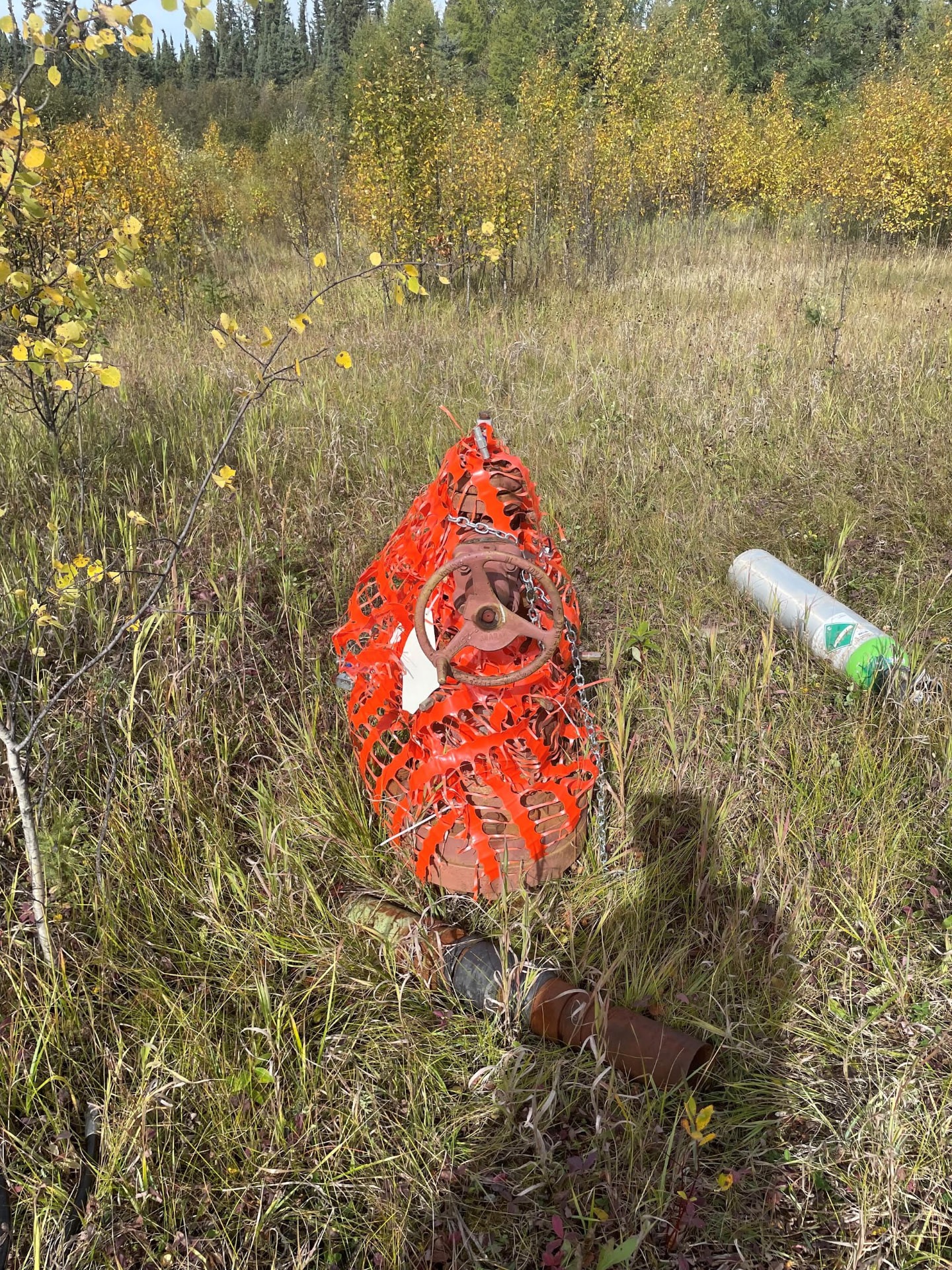

Project Photos
